See each phase of Skyline Queenstown’s construction timeline.

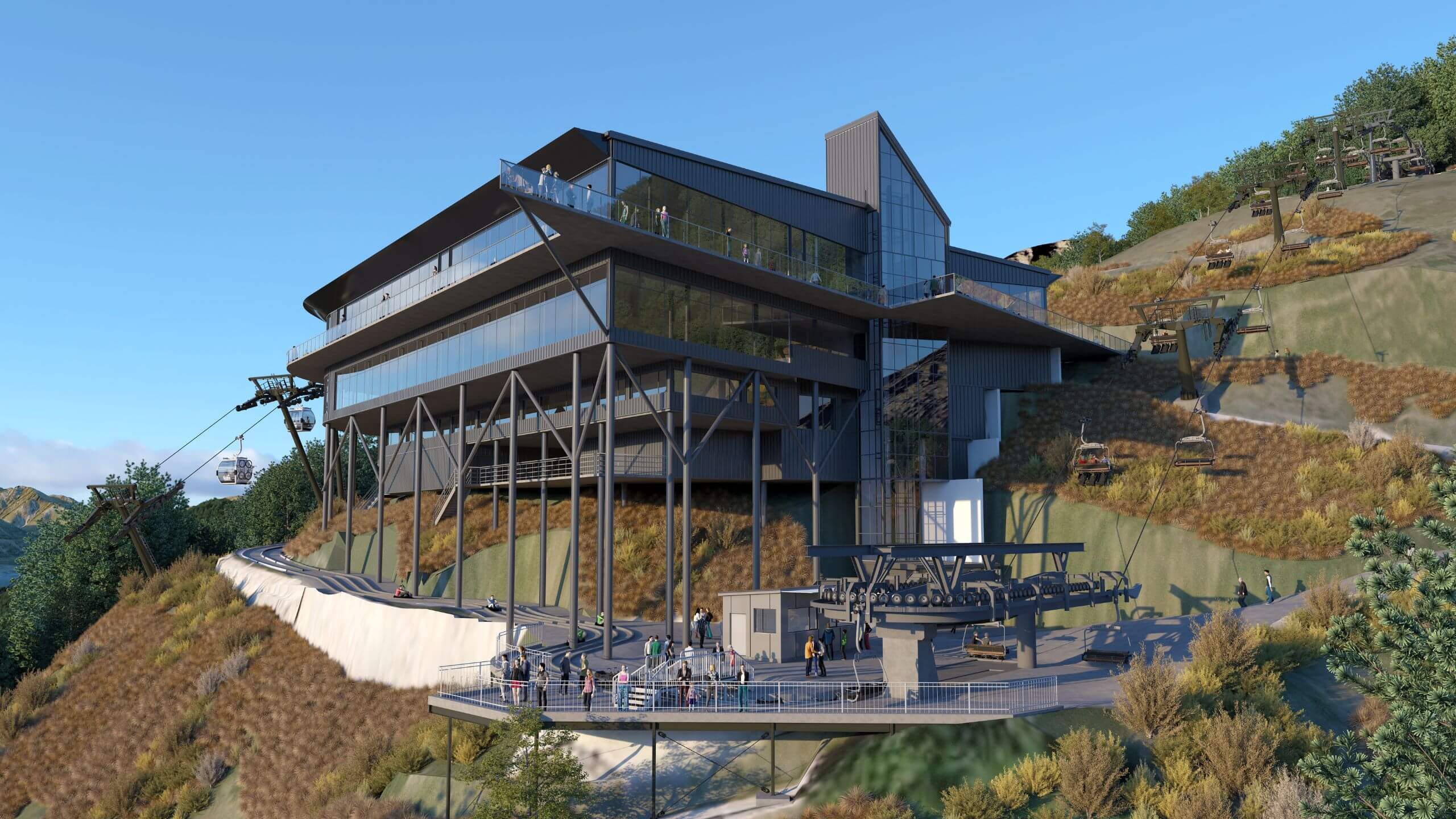

Skyline Queenstown New Building Render

Timeline of Transformation

Since 2019, Skyline Queenstown has been undergoing the largest upgrade in its history. Project Skyline is unfolding across five key phases, each one building toward a world-class visitor experience at the top of Bob’s Peak.

Here’s how we’ve transformed and what’s still to come

Phase 1 (Complete)

(March 2019 – April 2023)

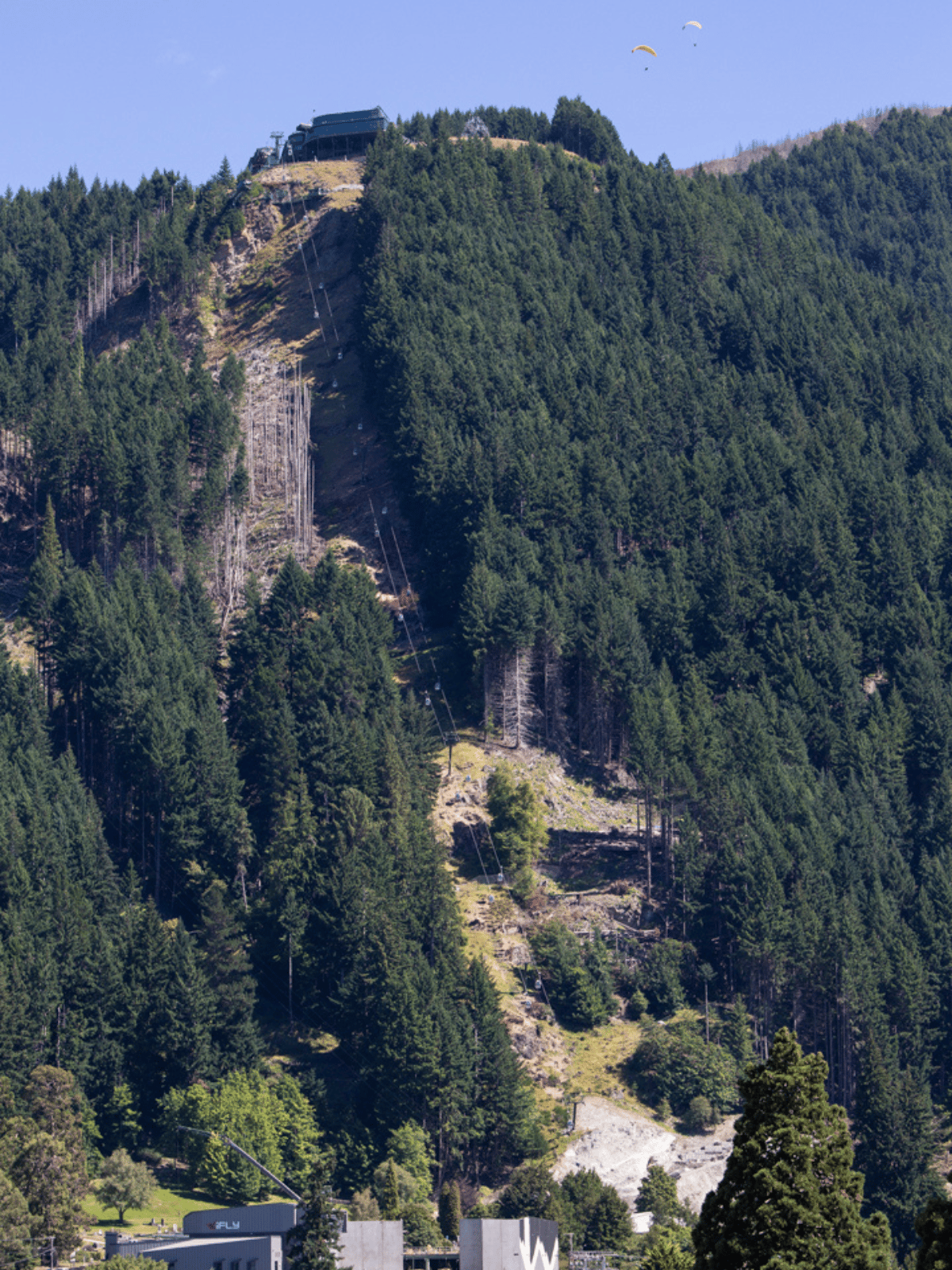

The groundwork for transformation began in 2019. This phase focused on preparing the terrain and infrastructure for major development.

Key milestones of Phase 1:

  • Tree removal along the Gondola corridor for safety and access
  • Rock retention to stabilise the terrain
  • Excavation for the new Base Terminal and multi-storey car park
  • Foundations laid for new 10-seat Gondola towers

Phase 2 (Complete)

(April 2023 – June 2023)

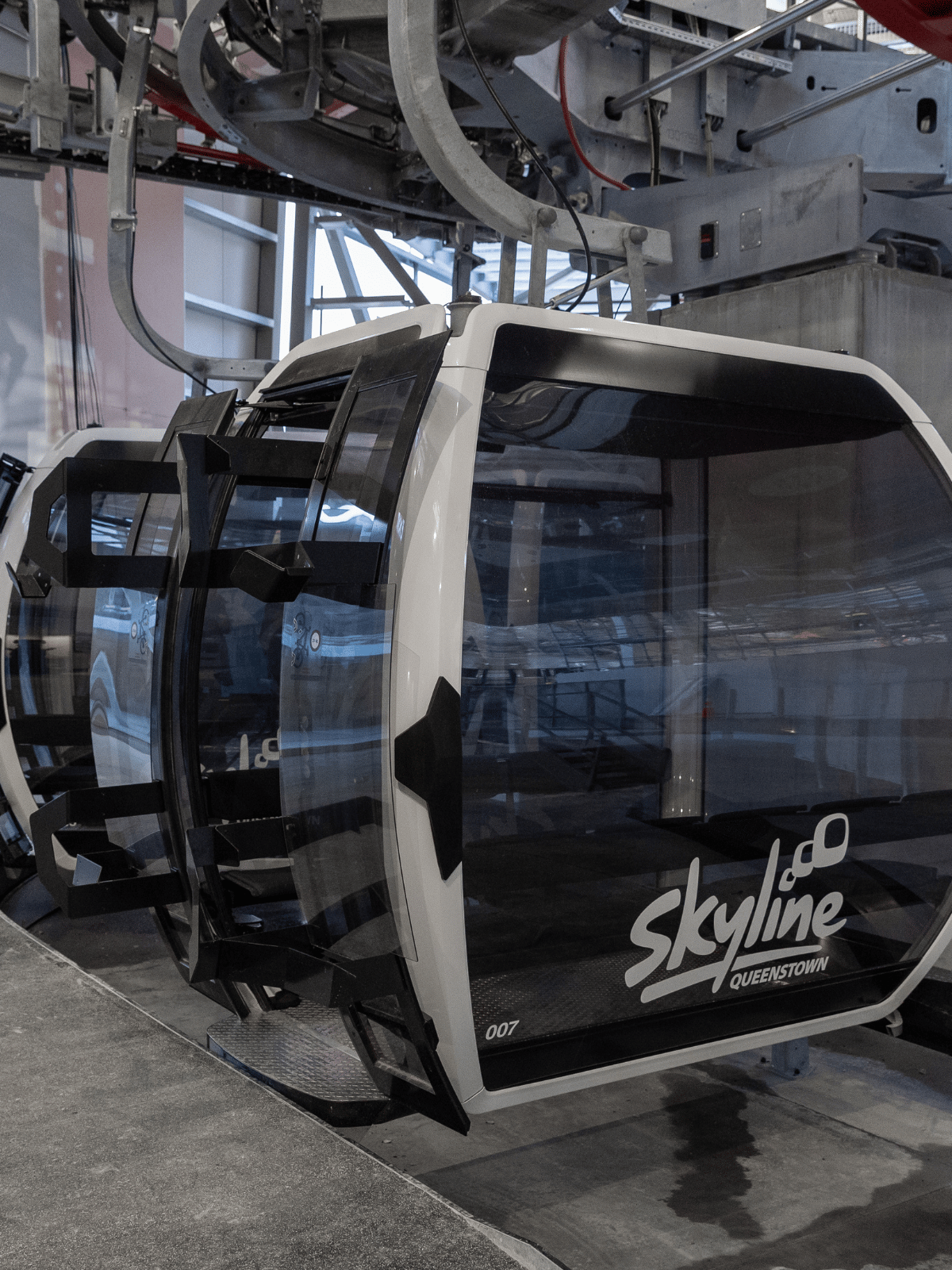

This phase marked a significant turning point in Skyline Queenstown’s history, with the transition to the new Gondola system.

Key milestones of Phase 2:

  • Skyline Queenstown was closed for 11 weeks to transition to the new Gondola system
  • Removed existing Gondola terminals and towers: Making way for the new state-of-the-art facilities
  • Constructed Base Terminal machine hall and back of house: Building the essential infrastructure to support
  • Established a temporary ticketing building at the base terminal: Ensuring a smooth customer experience during the transition
  • Constructed the top Gondola terminal building: Creating a modern and welcoming arrival point at the summit

Phase 3 (Complete)

(June 2023 – April 2024)

With the new Gondola launched in June 2023, this phase was all about completing the guest arrival experience.

Key milestones of Phase 3:

  • Base Terminal ticketing hall completed
  • Multi-storey car park finished for easier access
  • Brecon Street streetscape upgrades for improved flow and aesthetics
  • Official opening of the new Base Terminal and car park in early 2024

The Skyline Queenstown Vortex Slide experience

Phase 4 (Complete)

(August 2023 – March 2026)

This phase marks the beginning of the full redevelopment of the top complex at Bob’s Peak

Key milestones of Phase 4:

  • August 2023: Construction of a new extension begins
  • September 2025: Civil works begin to form new Luge entrance
  • March 2026: Building extension, Luge access and landscaping complete

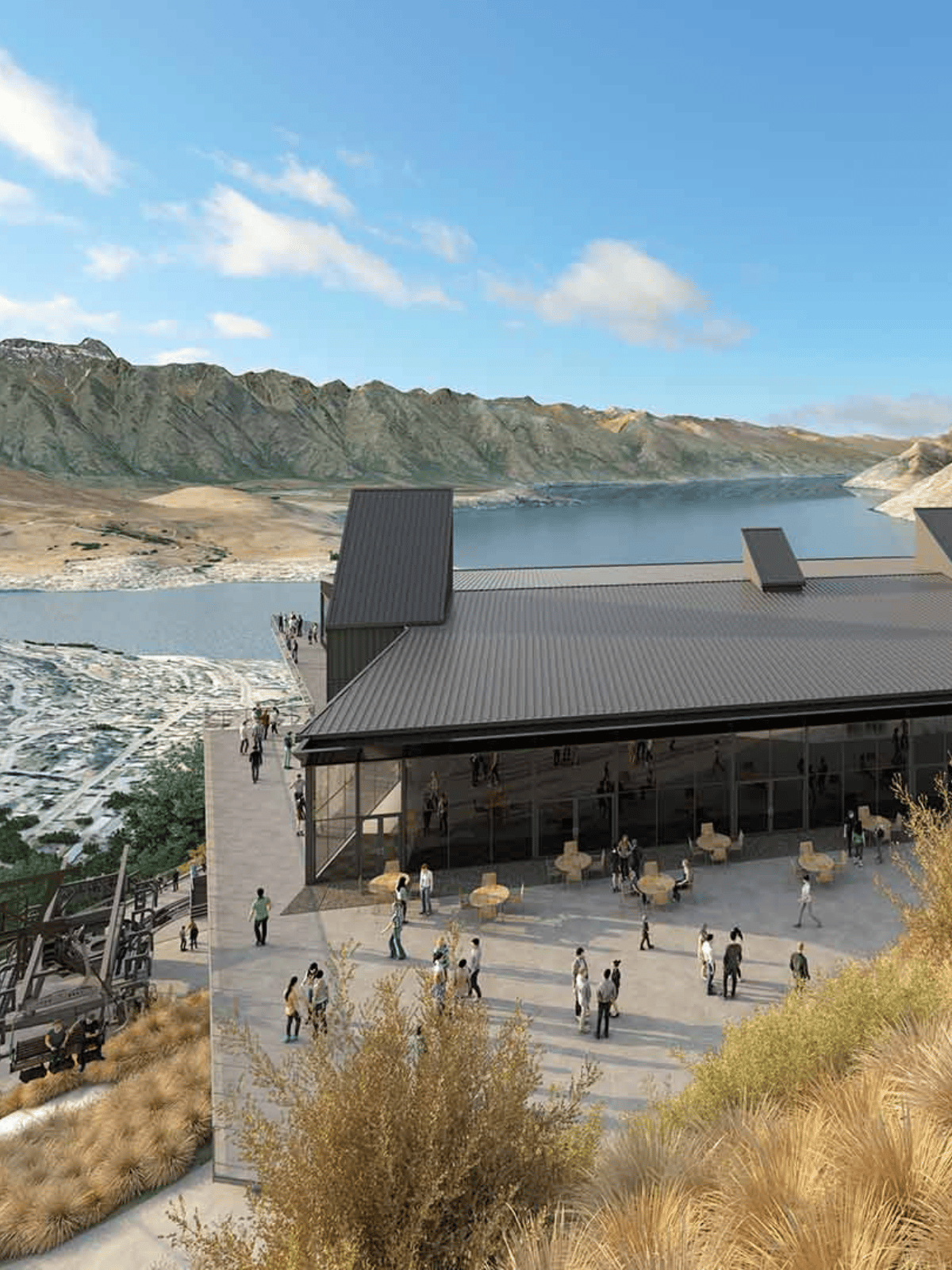

Phase 5 (Current)

(March 2026 – Early 2029)

This phase marks the final works in the Skyline Redevelopment project.

Key milestones of Phase 5:

  • Phased demolition of the original Top Complex begins
  • 2026–2028: Rebuild and integration of new and existing sections
  • Early 2029: Full Top Complex transformation complete
